|
Kiev Sights | Object 1 Stalin Tunnels Under Dnieper River
Individual and group tours to Kiev |
The idea of building of Tunnels under Dnieper Riverbelonged to Joseph Stalin and main responsible official for the construction of tunnels was Nikita Khrushchev. Object 1 was strictly kept secret. The construction of tunnels under Dnieper river was conducted by workers of trust "Hydrostroy" and employed workers who were carefully selected by NKVD. Workers of Object 1 could not quit their job even during Great Patriotic War all employees were exempt from military service.
Initially according to regulations on works for construction of Tunnels under Dnieper River hired about 2500 people.

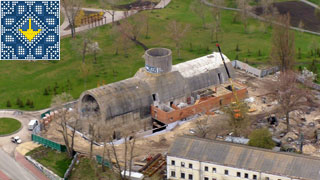

Construction of Tunnels under Dnieper River began with the caisson - construction for creating a chamber with no water in water-saturated soil. Admission of water into the working chamber is prevented by injecting compressed air into it. Caisson typically constructed on the surface (17 meters * 52 meters) and by special procedure sinked underground under its own weight. When the caisson was at depth of 30-40 meters began horizontal construction of tunnel using tunnel boring machine. The tunnel boring machine was non-mechanized. In its working chamber pumped air (up to a pressure of 2-5 atm) which pressed water from aquifers and do not let it to came inside of working chamber. The method is very efficient from an engineering point of view but it is extremely harmful to health of workers because it caused decompression sickness.
For the team of ten people was a record to mount one ring for one shift. Construction of Tunnels under Dnieper River was carried out day and night in three shifts. Duration of shift changed depends on pressure in the tunnel - 6 hours at a pressure of 1 atm, 40 minutes - at 4 atm. Construction of both tunnels were divided into separate independent production units so-called "title" from number 1 to number 14. For construction of tunnels were done al lot of groundwork - river bank stabilization, warehouses, provision of electricity, water supply and communications, construction of road and rail sidings, houses for workers and more.
The design length of South Tunnel under Dnieper river was 6,5 km. It was planned that the trains under Dnieper river will move in two directions and the rails will be possible to close by boards so that it can pass cars or tanks. Construction of South Tunnel under Dnieper river should be completed in 1944 by initial plans. In February 1941 on tunnel boring machine which was moving towards the left bank of Dnieper river happened a big accident. In the area of quicksands the air from the tunnel under the pressure of 2,8 atm suddenly burst to the surface creating the whirlpool that filled the tunnel with water. Workers had enough time to escape. Tunnel boring machine bent face down on blurred ground. Head of "Title №4" was fired and in March appointed new one - engineer Isaac Barenboim who is well-established as the head of "Title №5". The tunnel boring machine was renovated in early July 1941 when Germans were on the outskirts of Kiev.
On 6th of August 1944 State Defense Committee of Soviet Union (USSR) adopted a resolution №6326 on the resumption of construction of South Tunnel under Dnieper river but soon at the end of 1949 the construction was stopped as unprofitable. Then in 50s from South Tunnel took out a lot of pipes which were used in the construction of Kiev Subway for stations "Polytechnic Institute" and "Vokzalnaya" (Train Station). You could visit Ukraine Kiev Sights | Object 1 Stalin Tunnels Under Dnieper River as additional option to Kyiv Tour! |
